REACH Compliance for Valve Cover Gasket Sourcing

REACH compliance for valve cover gasket sourcing is a procurement control that should sit inside supplier qualification, not in a folder after the purchase order. A finished gasket can include several elastomer compounds, steel or aluminium carriers, bonded sleeves, primers, anti-stick coatings, adhesives, printed bags, labels, and kit items such as bolt grommets or spark plug tube seals. Each input may carry a different chemical risk.

For EU importers, the core question is simple: can the supplier show, by part number and material route, whether any substance of very high concern (SVHC) on the Candidate List is present above the 0.1% weight-by-weight communication threshold in the article or relevant sub-article? Under REACH (EC) No 1907/2006, that answer must be current, traceable, and connected to change control.

This guide gives aftermarket distributors, OEM/Tier-1 sourcing teams, and repair-chain buyers a practical way to evaluate valve cover gasket suppliers. It covers evidence requests, declaration review, escalation to testing, technical release, RFQ timing, MOQ, price, and lead-time trade-offs. Driventus controls gasket materials under IATF 16949:2016 and ISO 9001:2015. Driventus is an independent aftermarket manufacturer; brand names are referenced for fitment only.

Decision point: what REACH actually changes in a gasket sourcing decision

REACH does not turn a valve cover gasket into a chemical product. In most cases, the gasket is an article because its sealing function comes mainly from shape, groove fit, bead geometry, and installed compression, not from intentional chemical release. That distinction matters, but it does not remove the buyer’s duty to understand substances in the supplied article.

The purchasing decision should change when any of the following points are weak:

  • The supplier cannot confirm whether Candidate List SVHCs are present above 0.1% w/w in the finished article or in separable kit sub-articles such as grommets, sleeves, carriers, labels, bags, or inserts.
  • The declaration covers a factory or material family but not the actual valve cover gasket part numbers, drawing revision, material revision, kit contents, and packaging route.
  • Annex XVII restrictions are not addressed where relevant to elastomers, coatings, adhesives, inserts, processing oils, pigments, and packaging.
  • Candidate List updates are not reviewed after ECHA changes, or the supplier cannot state the review date used for the declaration.
  • Material, process, tooling, coating, adhesive, packaging, production-site, or sub-supplier changes can happen without compliance re-evaluation before shipment.

A valve cover gasket may use VMQ silicone rubber for high heat areas, ACM or AEM for oil and heat resistance, FKM for demanding chemical exposure, NBR or HNBR for selected oil applications, EPDM where oil exposure is not the main load, and steel or aluminium carriers for supported designs. Service environments often include continuous temperatures around 120–180°C, short peaks above that depending on engine layout, oil vapour, crankcase gases, and repeated compression-relaxation cycles.

Those materials do not carry the same compliance profile. Rubber compounds may include accelerators, fillers, pigments, processing oils, plasticisers, anti-ageing additives, peroxide or sulphur curing systems, and mould-release residues. Metal inserts may involve zinc-based coatings, passivation, oils, or corrosion inhibitors. Packaging adds another layer: inks, labels, recycled paper, printed films, desiccants, and retail inserts.

Reject one-line declarations that lack product scope, issuer identity, declaration date, regulation reference, Candidate List review date, Annex XVII statement, material family, and authorised signature. A usable declaration should say which part numbers, drawings, kit contents, materials, and packaging are covered. It should also state whether the SVHC content is below or above the 0.1% threshold for the supplied article or relevant sub-article.

Chemical compliance still has to be paired with technical control: dimensional capability, oil resistance, compression set, heat ageing, installation fit, and export packaging. Buyers can review related product families in our catalog and engine sealing components under engine components.

Workflow: build the REACH file before the first purchase order

The safest time to check REACH compliance for valve cover gasket programmes is before tooling approval, sampling, or supplier nomination. After the first shipment is packed, missing evidence becomes a schedule problem.

Use this workflow:

1. Define the commercial and technical scope. List valve cover gasket references, engine families, drawings, material types, kit contents, packaging format, annual volume, destination market, and accessories such as bolt grommets, spark plug tube seals, half-moon plugs, sleeves, washers, bonded inserts, or instruction sheets. 2. Map the bill of material by risk. Separate the main elastomer, secondary rubber parts, carrier metal, coating, adhesive, primer, lubricant, colour mark, bag, label, carton, and desiccant. Mark each item as low, medium, or high risk based on substance complexity, supplier control, and EU market exposure. 3. Request declarations early. Ask for a signed REACH declaration, Candidate List review date, Annex XVII statement where applicable, material family confirmation, and packaging statement before sample release or production booking. 4. Check the scope line by line. Confirm that the documents cover the exact gasket part numbers, product family, drawing revision, material revision, kit contents, and packaging specification. A factory-wide statement is not enough. 5. Interrogate higher-risk inputs. Pay attention to plasticisers, processing aids, pigments, flame retardants, rubber accelerators, anti-ageing additives, adhesives, primers, surface treatments, recycled packaging, printed films, and materials supplied by an external mixer. 6. Lock the change-control triggers. Require notification before changes to compound recipe, raw material supplier, carrier material, coating, mould release agent, adhesive, colour marker, packaging, manufacturing site, or sub-supplier. For controlled programmes, shipment after a change should require buyer approval. 7. Keep lot traceability usable. Link purchase orders, part numbers, batch numbers, material lot numbers, mould or cavity IDs where relevant, production dates, incoming inspection data, packing lists, carton labels, and compliance files. A practical audit target is traceability from finished gasket lot back to rubber compound lot within 24 hours. 8. Escalate when evidence is thin. If documentation is incomplete, the material route is complex, the compound contains unknown additives, or the end customer requires proof, request targeted SVHC or restricted-substance screening from a recognised third-party lab. The test sample ID must match the actual material, part, packaging component, or production lot. 9. Refresh the file. Candidate List updates can change communication duties. Many buyers refresh stable programmes annually, with immediate review after Candidate List updates, compound changes, packaging changes, supplier change notices, or customer audit findings.

Build time and cost into the RFQ. Existing catalogue gaskets with approved materials usually move faster than new bonded or special-compound parts. As a planning range, allow 3–7 working days for document collection on active parts, 10–20 working days for third-party screening if needed, 2–4 weeks for first sample production on simple moulded parts when tooling exists, and 4–8 weeks or more for new tooling, bonded carriers, or custom compounds.

MOQ also follows the material route. Small aftermarket references may be quoted in hundreds of pieces. Custom compounds, private-label packaging, third-party testing, or special inspection plans can push quantities higher because compound batch size, carton configuration, and production setup have to be absorbed. Unit price should be compared with compliance workload, lab fees, tooling cost, inspection level, packaging, and annual call-off schedule.

Driventus manages these checks through its documented quality system, aligned with IATF 16949:2016 and ISO 9001:2015. The same change-control discipline used for dimensional approval and process validation also applies to restricted-substance control.

Evidence comparison: useful supplier file vs. weak paperwork

A compliance file should help a buyer answer a customer audit question months after delivery: what was supplied, under which material revision, with which declaration, against which Candidate List date, and in which shipment? If it cannot do that, it is too thin.

</tr></thead><tbody> </tbody></table>Separate legal compliance from performance validation. A REACH declaration does not prove temperature resistance, compression set, oil resistance, hardness, tensile strength, elongation, tear resistance, sealing function, or fitment accuracy. Those items need engineering evidence.

Version control is the difference between a file and a claim. Store evidence by part number, drawing revision, supplier, material revision, batch, shipment date, and declaration date. A practical naming convention is `part number + drawing revision + supplier + material revision + declaration date`. It makes retrieval faster when a distributor, repair-chain customer, customs contact, or internal auditor asks for proof.

For private-label programmes or special elastomer requirements, buyers can discuss custom manufacturing with documented material and compliance controls at the quotation stage. If third-party reports are required, define the lab standard, sample quantity, report language, target market, and cost responsibility in the RFQ. Otherwise, the quotation may change after nomination.

Failure modes: where gasket REACH reviews usually break down

Most REACH problems in valve cover gasket sourcing do not start with the finished gasket on the bench. They start with an unmapped accessory, a changed additive, a generic declaration, or a packaging component no one reviewed.

Common failure modes include:

  • The main rubber is checked, but the kit is not. Bolt grommets, tube seals, sleeves, half-moon seals, washers, and separate rubber parts may have different compounds or suppliers.
  • A metal carrier is treated as harmless. Surface treatments, anti-corrosion coatings, plating residues, passivation chemicals, cleaning agents, and residual process oils still need review.
  • Bonding chemicals are hidden in the process. Adhesive or primer systems for bonded rubber-to-metal designs can introduce restricted-substance questions that are absent from a simple moulded profile.
  • Surface aids are forgotten. Anti-stick coatings, installation lubricants, colour markers, part-identification marks, release agents, and handling aids can sit outside the drawing but inside the supplied article route.
  • Packaging is assumed out of scope. Printed bags, labels, inks, desiccants, recycled paper content, protective films, and retail inserts may be part of the supplied package and can trigger customer questions.
  • Aftermarket cross-references are mistaken for material specifications. An OE-style reference helps identify fitment. It does not define the actual compound, coating, insert, supplier, or compliance status of the aftermarket article.

Material risk varies by design. A simple moulded VMQ profile without inserts has a cleaner review path than a bonded gasket with metal carriers, coatings, printed retail packaging, and multiple accessories. High-volume EU distribution needs tighter document control because one substance issue can affect many downstream customers at once.

The chemical review should connect to measurable material specifications. Typical incoming checks for elastomer parts may include hardness tolerance such as ±5 Shore A from the approved value, visual flash limits agreed by drawing or sample, bead height tolerance based on the sealing design, and dimensional checks on critical areas such as bolt holes, plug tube seals, corners, and half-moon profiles. Performance validation often includes heat ageing, oil immersion, compression set, tensile strength, elongation, and tear strength using agreed customer or ISO/ASTM methods.

For replacement gaskets supplied by OE cross-reference, use fitment references carefully. A notation such as OE 06A… or OE 11251… may help identify application scope, but it does not confirm the compound, coating, insert, or compliance status of the supplied aftermarket part. The supplier must confirm the actual materials used, the market covered by the declaration, and any differences between catalogue, private-label, and OEM-style versions.

Driventus is an independent aftermarket manufacturer; brand names are referenced for fitment only. No vehicle manufacturer approval or endorsement is implied unless a buyer provides a separate, documented approval route through its own programme.

Spec deep-dive: pass REACH and still validate the sealing system

A gasket can be chemically compliant and still fail in the engine. Wrong bead height, poor compression recovery, weak oil resistance, over-trimming, deformation in export cartons, or a compound mismatch can create leaks regardless of the REACH file.

Treat REACH compliance for valve cover gasket sourcing as one release gate. Technical validation is another.

Recommended specification checkpoints:

  • Drawing revision and part-number cross-reference controlled in the RFQ and quotation package, including supersessions and engine-code coverage.
  • Elastomer family confirmed against engine temperature range, oil exposure, crankcase gases, cover material, and service environment.
  • Hardness target and tolerance agreed, commonly stated in Shore A with an allowed tolerance such as ±5 points unless the drawing requires otherwise.

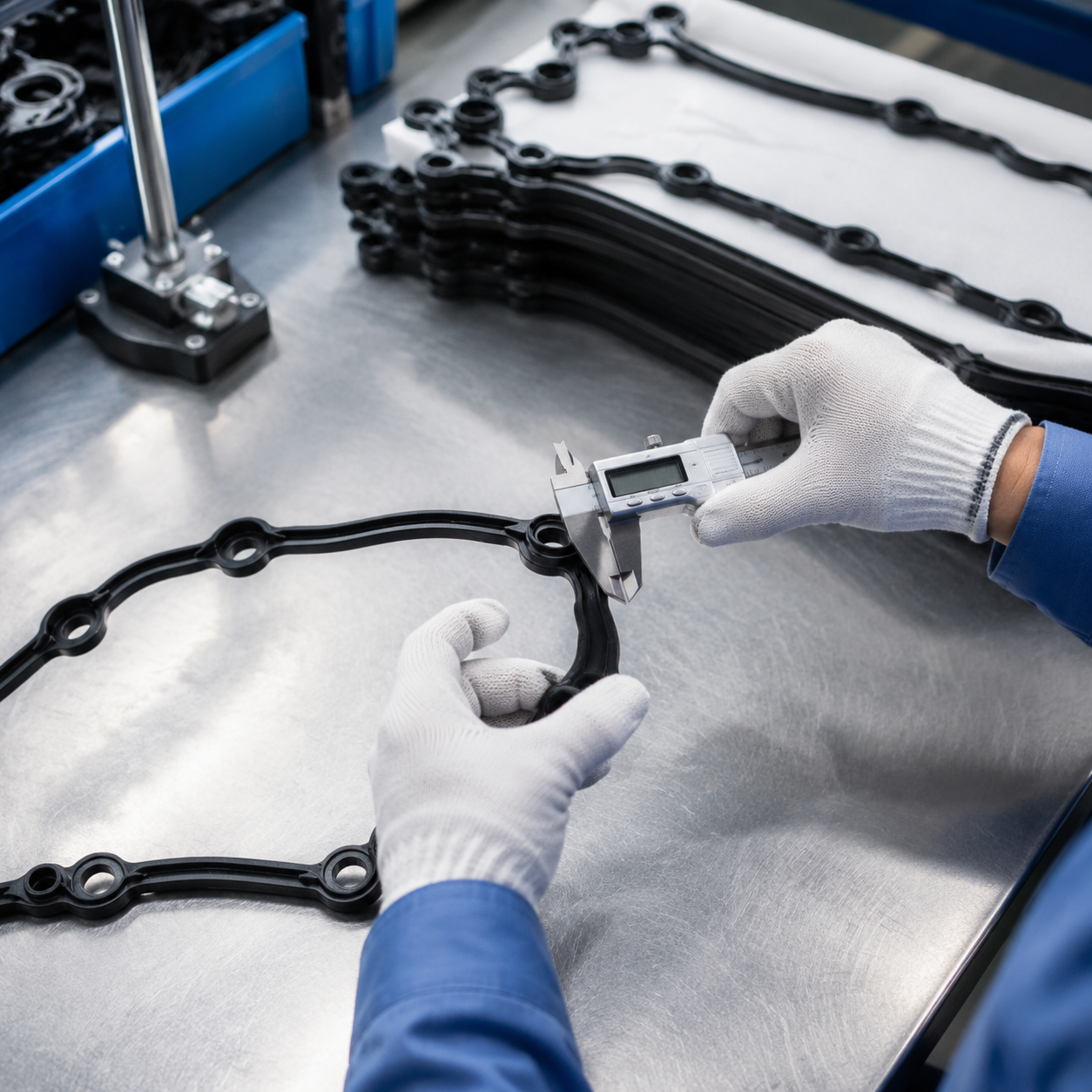

  • Critical dimensions measured by cavity where applicable, including bead height, groove width, bolt-hole spacing, corner radius, sealing lip thickness, carrier location, tube seal geometry, and half-moon profile.
  • Compression set tested after heat ageing according to a recognised internal or customer-approved method, with test temperature, time, compression percentage, and acceptance criteria stated in the report.
  • Oil resistance evaluated with relevant engine oil exposure conditions, including volume change, hardness change, tensile change, and visual cracking or swelling criteria where required.
  • Visual criteria defined for flash, cuts, contamination, voids, knit lines, underfill, over-trimming, deformation, trapped air, bond failure, coating damage, and carrier exposure.
  • Installation and packaging checks performed to reduce distortion, bending, sticking, compression marks, or deformation during export shipment.
  • Batch traceability retained from compounding and moulding through inspection, packing, warehousing, and shipment.

For OEM/Tier-1 projects, the approval package may include PPAP-style documentation, control plans, process flow diagrams, FMEA, measurement system analysis, initial sample inspection reports, capability data, material test summaries, and change-control records. For aftermarket distributors, a narrower package may be enough, but it should still include material confirmation, dimensional report, fitment confirmation, packaging approval, and a current compliance declaration.

Inspection depth should follow risk and volume. For a new or re-sourced gasket, buyers often request 100% visual inspection during initial production, cavity-level dimensional checks on the first batch, and AQL-based final inspection before shipment. Critical sealing dimensions may need tighter sampling than non-critical packaging attributes. If the part has several mould cavities, record data by cavity so recurring flash, short-shot, or dimensional drift can be isolated.

The rule is blunt: REACH controls chemical risk; it does not replace drawings, inspection data, process capability, material performance, or functional sealing validation. Both gates must pass before serial release, and both should be reopened after material, tooling, supplier, or process changes.

Supplier qualification Q&A before nomination

Before issuing a purchase order, use the supplier discussion to test whether the declaration is backed by a real operating system. The strongest suppliers can explain how they keep compliance current and how that discipline affects MOQ, price, samples, lead time, and repeat supply.

Ask these questions during qualification:

  • Who is responsible for REACH monitoring and Candidate List updates?
  • How often are REACH declarations reviewed and reissued, and what Candidate List date is currently used?
  • How are compound recipes approved, documented, and locked after sampling?
  • Are rubber compounds mixed in-house or purchased from an external mixer, and how are mixer changes controlled?
  • What is the minimum compound batch size, and how does it affect MOQ for low-volume references?
  • How are raw material batches linked to finished gasket lots and packing lists?
  • What happens if a raw material supplier changes an additive, processing aid, pigment, curing agent, or oil?
  • Which changes require customer notification before shipment?
  • How are mould cavities identified in inspection records and nonconformance reports?
  • Can the supplier provide dimensional reports for critical sealing features by cavity or production lot?
  • What are the normal lead times for catalogue parts, first samples, new tooling, private-label packaging, and third-party chemical testing?
  • Are nonconforming parts segregated, labelled, and dispositioned under documented controls?
  • Does the supplier maintain IATF 16949:2016 and ISO 9001:2015 certification or work under equivalent documented procedures?
  • Can compliance declarations, material confirmations, inspection reports, packing photos, and traceability records be supplied before shipment?

Listen for specifics. If the supplier cannot name the compliance owner, explain Candidate List review timing, identify material-change triggers, or trace batches through production and packing, the buyer may inherit the risk after the goods arrive. For regulated or high-volume programmes, close those gaps before commercial release.

Then test the quotation against the technical file. A lower unit price may depend on a substitute compound, simplified packaging, larger MOQ, fewer inspections, or no third-party testing. A higher price may be justified where it includes a special elastomer, bonded carrier processing, private-label cartons, tighter dimensional control, REACH documentation, PPAP-style records, or lab screening. Ask suppliers to separate tooling, sample, test, packaging, and serial unit price so decisions are transparent.

Driventus manufactures engine and powertrain components in Taizhou, Zhejiang, and exports to distributors, wholesalers, OEM/Tier-1 customers, and multi-location repair groups in more than 60 countries. For valve cover gasket projects, procurement teams can request a quote with drawings, sample parts, OE cross-references for fitment, annual volume, target MOQ, target market, packaging requirements, required test reports, and compliance documentation needs.

Frequently asked questions

No. A REACH declaration addresses chemical compliance under REACH (EC) No 1907/2006. Sealing performance still requires separate validation, including dimensional inspection, material selection, heat ageing, oil resistance, compression set review, hardness checks, visual criteria, packaging review, and fitment checks.

Many buyers refresh declarations annually and whenever the Candidate List changes, the compound changes, or the supplier changes any coating, adhesive, packaging, raw material source, production site, external mixer, or production route. High-volume or EU-focused programmes may need review after each Candidate List update and before major shipments.

Yes. Driventus can provide project-specific documentation for valve cover gasket programmes, including product scope, material confirmation, REACH declaration, traceability information, inspection records, and agreed test reports aligned with customer requirements, MOQ, lead time, and packaging needs.

If you are qualifying a valve cover gasket supplier for EU or global distribution, share the target references, drawings, samples, annual volume, target MOQ, target price range, target market, packaging requirements, required test reports, and compliance documentation needs. Driventus can review the scope and respond with a practical quotation package at /contact.html

Request a Quote
Document What a useful version shows Buyer check
REACH declarationRegulation reference, Candidate List status, 0.1% w/w statement, product scope, date, authorised signatureConfirm it covers the supplied valve cover gasket family, kit contents, packaging, and current Candidate List review
Material declarationElastomer family, hardness target if disclosed, insert material, coating or adhesive class, packaging scope where relevantCompare with approved drawing, sample approval, PPAP file, incoming inspection plan, and quotation assumptions
Safety data sheet, where relevantInformation for supplied compounds, uncured materials, adhesives, coatings, primers, oils, or chemical preparationsCheck for restricted substances, handling controls, and consistency with the declared material system
Annex XVII statementConfirmation that relevant restrictions are reviewed for the supplied article and its materialsVerify that it is not limited to unrelated products, only raw materials, or non-EU requirements
Change notification procedureTriggers for compound, supplier, process, tooling, site, coating, adhesive, colour mark, or packaging changesConfirm advance notice before shipment and written approval before implementation on controlled parts
Test report, if requestedScreening result for SVHCs or restricted substances, sample identification, method, date, result units, detection limits, and lab informationCheck that the tested sample matches the supplied gasket, material, production lot, or packaging component
Traceability recordBatch, lot, mould cavity where applicable, production date, inspection status, packing reference, and shipment numberLink to purchase order, invoice, packing list, incoming inspection record, and customer delivery
Technical validation fileDimensional report, material test summary, fitment check, and inspection criteriaKeep separate from REACH evidence but approve both before serial release
